Plastic Tooling Development and Validation Explained

Minimalist green outline of a traditional razor blade on a black background.

Tooling is the largest single capital decision in plastic product development. Here's how a well-designed mould is built, validated and managed for the long haul.

An injection mould - what most people just call a "tool" - is a precision steel or aluminium block, machined to extraordinary tolerances, that produces the same part thousands or millions of times. It is the foundation of plastic manufacturing. Get the tool right, and production is straightforward. Get the tool wrong, and every single part it produces will inherit the problem.

This page explains how plastic tooling is developed and validated at B&C Plastics, what you can expect from the process, and how to make smart decisions about an investment that will affect your product for years.

Green infographic with certification icons and text for ISO standards in quality management, environmental management, and health and safety management.
A person at a gym lifting weights with a barbell overhead.

Combining full ISO certification with DISP accreditation, B&C Plastics provides high-quality, secure, and traceable plastic injection moulded components engineered for reliability and performance.

What goes into a plastic injection mould

A typical production injection mould is far more than two halves of steel with a cavity in the middle. A well-designed tool includes:

  • Cavity and core: the negative geometry of the part itself

  • Runner and gate system: the channels that deliver molten plastic to the cavity

  • Cooling channels: precision-drilled water lines that control how the part cools

  • Ejector system: pins, sleeves or strippers that push the part out at the end of each cycle

  • Slides, lifters and unscrewing mechanisms: for undercuts, threads and complex geometry

  • Venting: tiny pathways that let air escape so the cavity fills cleanly

  • Wear plates, alignment features and tool steel selection: everything that makes the tool last

Tool classes and what they cost

Not every tool needs to be a million-cycle production powerhouse. The right tool for the job depends on volume, complexity, polymer abrasiveness and project economics.

Tool type Typical life Best for
Prototype / soft tool 1,000 - 10,000 shots Market trials, bridge production, pre-launch validation
Pilot tool (P20 steel) 100,000 - 250,000 shots Lower-volume production, niche products
Production tool (H13 / S136) 500,000 - 1,000,000+ shots Full production, abrasive materials, glass-filled polymers
Multi-cavity production tool 500,000+ cycles per cavity High-volume production where unit cost matters

The right tool is the one that matches your forecast volume and lifecycle. Over-tooling wastes capital. Under-tooling wastes parts.

How tooling is developed at B&C Plastics

Our tooling process is designed to catch problems before they become steel - because steel is hard to change.

Stage 1 - DFM and material lock

Before any tool design starts, we sign off on the part design and material. This is the cheapest place to make changes. See our Design for Manufacture page for the detail of what this involves.

Stage 2 - Tool design and mould flow analysis

Our tool designers translate the part design into a tool design - choosing parting lines, gate location, ejector strategy, cooling layout, slide actions and steel selection. Mould flow analysis simulates exactly how plastic will fill the cavity, where weld lines will form, and where pressure or temperature problems will occur. We refine the design until the simulation is clean.

Stage 3 - Tool build

CNC machining, EDM, polishing and assembly. For most production tools this takes 8 to 14 weeks. We can build tooling locally or, where it makes commercial sense, partner with vetted offshore toolmakers under our quality oversight - your choice, transparently costed.

Stage 4 - Tool trial (T1, T2, T3)

First sample shots from the new tool. T1 is the first attempt - almost always followed by adjustments. T2 and T3 refine the tool until parts meet the agreed specification. Every change is documented.

Stage 5 - Validation and sign-off

First-off articles are inspected against the approved CAD and drawing package. Dimensions, surface finish, weight, fit and any specified mechanical or aesthetic properties are checked and documented. You sign off before production starts.

Stage 6 - Production process validation

Locking in the moulding parameters that produce good parts repeatably - temperatures, pressures, hold times, cycle times. For regulated industries we can produce PPAP-style documentation.

Tool validation - what "signed off" actually means

A validated tool is one that can be relied on to produce parts within specification, run after run. Validation includes:

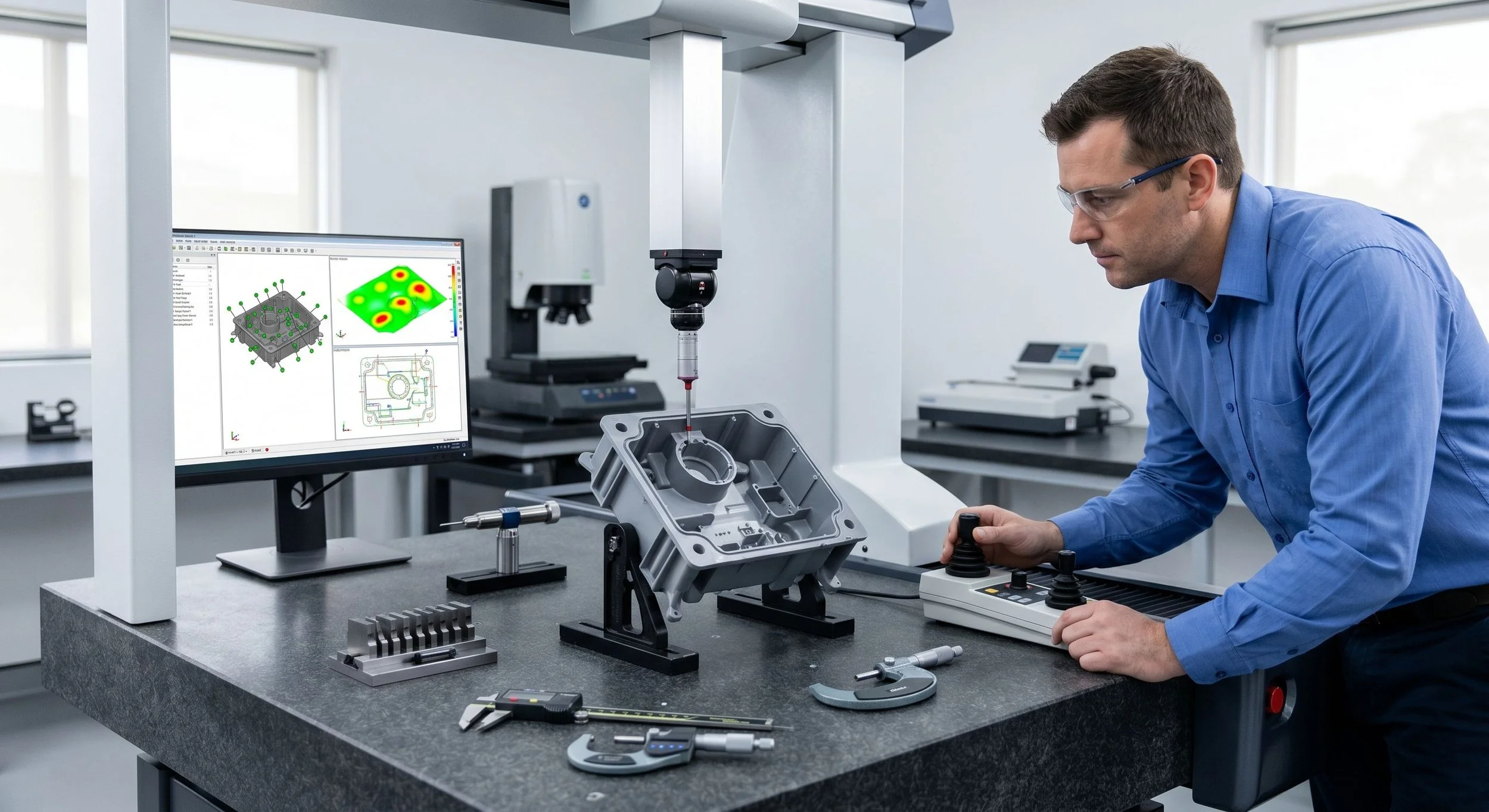

  • Dimensional inspection of first-off articles using CMM and metrology equipment

  • Visual and surface finish inspection against agreed standards

  • Functional testing of features such as snap-fits, threads, mating surfaces

  • Weight and shot consistency verification

  • Cycle time confirmation against forecast unit cost

  • Documentation package: inspection records, mould flow report, process parameters

Tool ownership, storage and lifecycle

Unless agreed otherwise in writing, tools we build for you are owned by you. They live in our facility because that is where they get used, but they belong to your business and they can be moved if you ever need to.

We maintain a tool register so we know exactly where every tool is, when it last ran, how many shots it has accumulated and when it last had preventive maintenance. Production tools are routinely cleaned, inspected and serviced to maximise life.

  • All tools individually catalogued and shot-counted

  • Routine preventive maintenance scheduled by shot count and time

  • Insurance arrangements available on request

  • Wear-part replacement tracked and budgeted

  • Spare cavity and ejector components held for high-priority tools

When tools need refurbishment or replacement

Even well-built tools eventually wear. Signs that a tool needs attention include flash at the parting line, dimensional drift, ejector marks, gate erosion or longer-than-expected cycle times. We track these signals and proactively recommend refurbishment before quality is affected.

For tools nearing end of life, we can plan a replacement build well in advance so there is no break in supply. For tools with seasonal demand, we can schedule maintenance windows to align with low-demand periods.

Frequently asked questions

  • Most production tools take 8 to 14 weeks from design release to first sample. Multi-cavity or highly complex tools can take longer. Soft or pilot tools can be ready in 4 to 8 weeks.

  • It depends on size, complexity, cavitation and steel selection. As a guide, a single-cavity production tool for a small-to-medium part typically costs $15,000 to $50,000. Larger or multi-cavity tools can run $50,000 to $250,000+. We give you a transparent quote before any commitment.

  • Yes, in most cases. We can receive existing tools, inspect and re-validate them on our machines, and run production from them. We will tell you honestly if a tool needs refurbishment before it can run reliably.

  • Our process includes routine maintenance to prevent damage in the first place. If damage occurs, we will assess, quote and complete repairs through our in-house tooling team. For tools you want covered, we can recommend insurance arrangements.
